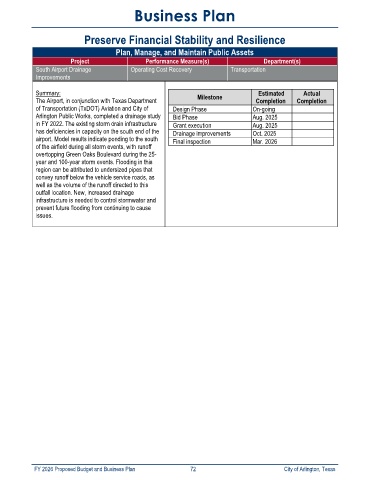

Business Plan





                             Preserve Financial Stability and Resilience
                                       Plan, Manage, and Maintain Public Assets

                        Project                  Performance Measure(s)                 Department(s)
             South Airport Drainage         Operating Cost Recovery          Transportation
             Improvements

             Summary:                                                                  Estimated     Actual
             The Airport, in conjunction with Texas Department    Milestone           Completion      Completion
             of Transportation (TxDOT) Aviation and City of   Design Phase           On-going
             Arlington Public Works, completed a drainage study   Bid Phase          Aug. 2025
             in FY 2022. The existing storm drain infrastructure   Grant execution   Aug. 2025
             has deficiencies in capacity on the south end of the   Drainage improvements    Oct. 2025
             airport. Model results indicate ponding to the south   Final inspection   Mar. 2026
             of the airfield during all storm events, with runoff
             overtopping Green Oaks Boulevard during the 25-
             year and 100-year storm events. Flooding in this
             region can be attributed to undersized pipes that
             convey runoff below the vehicle service roads, as
             well as the volume of the runoff directed to this
             outfall location. New, increased drainage
             infrastructure is needed to control stormwater and
             prevent future flooding from continuing to cause
             issues.
