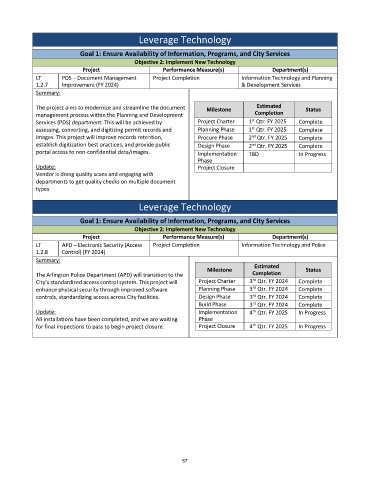

Leverage Technology

                            Goal 1: Ensure Availability of Information, Programs, and City Services
                                              Objective 2: Implement New Technology
                            Project                    Performance Measure(s)              Department(s)
             LT       PDS – Document Management     Project Completion           Information Technology and Planning
             1.2.7    Improvement (FY 2024)                                      & Development Services
             Summary:

             The project aims to modernize and streamline the document   Milestone    Estimated       Status
             management process within the Planning and Development                  Completion
                                                                                    st
             Services (PDS) department. This will be achieved by   Project Charter   1  Qtr. FY 2025   Complete
                                                                                    st
             assessing, converting, and digitizing permit records and   Planning Phase   1  Qtr. FY 2025   Complete
             images. This project will improve records retention,   Procure Phase   2 Qtr. FY 2025   Complete
                                                                                    nd
             establish digitization best practices, and provide public   Design Phase   2 Qtr. FY 2025   Complete
                                                                                    nd
             portal access to non‐confidential data/images.       Implementation   TBD              In Progress
                                                                  Phase
             Update:                                              Project Closure
             Vendor is doing quality scans and engaging with
             departments to get quality checks on multiple document
             types


                                               Leverage Technology

                            Goal 1: Ensure Availability of Information, Programs, and City Services
                                              Objective 2: Implement New Technology
                            Project                    Performance Measure(s)              Department(s)
             LT       APD – Electronic Security (Access   Project Completion     Information Technology and Police
             1.2.8    Control) (FY 2024)
             Summary:
                                                                                     Estimated
                                                                      Milestone                       Status
             The Arlington Police Department (APD) will transition to the            Completion
                                                                                     rd
             City’s standardized access control system. This project will   Project Charter   3  Qtr. FY 2024   Complete
                                                                                     rd
             enhance physical security through improved software   Planning Phase   3  Qtr. FY 2024   Complete
                                                                                     rd
             controls, standardizing access across City facilities.   Design Phase   3  Qtr. FY 2024   Complete
                                                                                     rd
                                                                   Build Phase      3  Qtr. FY 2024   Complete
             Update:                                               Implementation   4  Qtr. FY 2025   In Progress
                                                                                     th
             All installations have been completed, and we are waiting   Phase
                                                                                     th
             for final inspections to pass to begin project closure.   Project Closure   4  Qtr. FY 2025   In Progress























                                                             57
