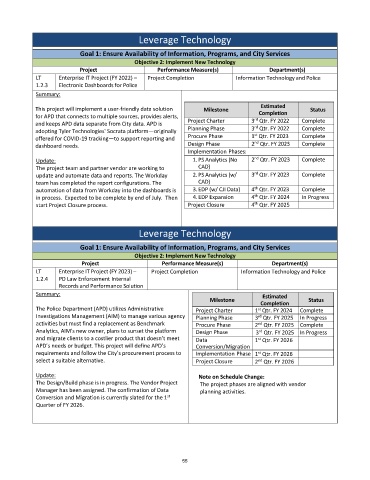

Page 349 - CityofArlingtonFY26AdoptedBudget
P. 349

Leverage Technology

                            Goal 1: Ensure Availability of Information, Programs, and City Services
                                              Objective 2: Implement New Technology
                           Project                   Performance Measure(s)               Department(s)
             LT     Enterprise IT Project (FY 2022) –   Project Completion     Information Technology and Police
             1.2.3   Electronic Dashboards for Police
             Summary:
                                                                                       Estimated
             This project will implement a user-friendly data solution   Milestone                      Status
             for APD that connects to multiple sources, provides alerts,               Completion
                                                                                     rd
                                                               Project Charter      3  Qtr. FY 2022   Complete
             and keeps APD data separate from City data. APD is
                                                                                     rd
                                                               Planning Phase       3  Qtr. FY 2022   Complete
             adopting Tyler Technologies' Socrata platform—originally                st
             offered for COVID-19 tracking—to support reporting and   Procure Phase   1  Qtr. FY 2023   Complete
                                                                                     nd
             dashboard needs.                                  Design Phase         2  Qtr. FY 2023   Complete
                                                               Implementation Phases:
                                                                                     nd
             Update:                                             1. PS Analytics (No   2  Qtr. FY 2023   Complete
             The project team and partner vendor are working to    CAD)
                                                                                     rd
             update and automate data and reports. The Workday   2. PS Analytics (w/   3  Qtr. FY 2023   Complete
             team has completed the report configurations. The     CAD)
                                                                                     th
             automation of data from Workday into the dashboards is   3. EDP (w/ CJI Data)  4  Qtr. FY 2023   Complete
                                                                                     th
             in process.  Expected to be complete by end of July.  Then   4. EDP Expansion  4  Qtr. FY 2024   In Progress
                                                                                     th
             start Project Closure process.                    Project Closure      4  Qtr. FY 2025
                                               Leverage Technology

                            Goal 1: Ensure Availability of Information, Programs, and City Services
                                              Objective 2: Implement New Technology
                            Project                    Performance Measure(s)              Department(s)
             LT     Enterprise IT Project (FY 2023) –   Project Completion       Information Technology and Police
             1.2.4   PD Law Enforcement Internal
                     Records and Performance Solution
             Summary:                                                                   Estimated
                                                                      Milestone                        Status
                                                                                       Completion
             The Police Department (APD) utilizes Administrative   Project Charter   1  Qtr. FY 2024   Complete
                                                                                      st
             Investigations Management (AIM) to manage various agency   Planning Phase   3  Qtr. FY 2025   In Progress
                                                                                      rd
             activities but must find a replacement as Benchmark   Procure Phase     2  Qtr. FY 2025   Complete
                                                                                      nd
             Analytics, AIM's new owner, plans to sunset the platform   Design Phase     rd
                                                                                      3  Qtr. FY 2025   In Progress
             and migrate clients to a costlier product that doesn’t meet   Data      1  Qtr. FY 2026
                                                                                      st
             APD’s needs or budget. This project will define APD’s   Conversion/Migration
             requirements and follow the City’s procurement process to   Implementation Phase  1  Qtr. FY 2026
                                                                                      st
             select a suitable alternative.                       Project Closure    2  Qtr. FY 2026
                                                                                      nd
             Update:                                               Note on Schedule Change:
             The Design/Build phase is in progress. The Vendor Project    The project phases are aligned with vendor
             Manager has been assigned. The confirmation of Data    planning activities.
             Conversion and Migration is currently slated for the 1
                                                        st
             Quarter of FY 2026.
