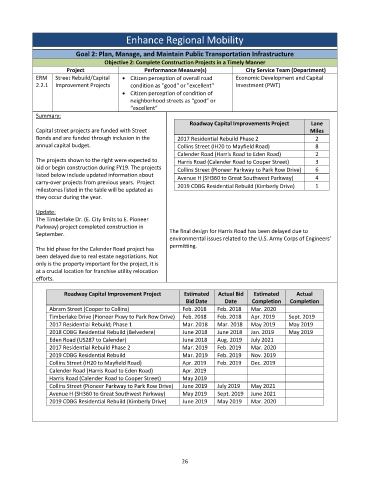

Enhance Regional Mobility


                          Goal 2: Plan, Manage, and Maintain Public Transportation Infrastructure
                                    Objective 2: Complete Construction Projects in a Timely Manner
                       Project                   Performance Measure(s)           City Service Team (Department)
             ERM   Street Rebuild/Capital     Citizen perception of overall road   Economic Development and Capital
             2.2.1  Improvement Projects    condition as "good" or "excellent"    Investment (PWT)
                                           Citizen perception of condition of
                                            neighborhood streets as “good” or
                                            “excellent”
             Summary:
                                                                Roadway Capital Improvements Project    Lane
             Capital street projects are funded with Street                                             Miles
             Bonds and are funded through inclusion in the   2017 Residential Rebuild Phase 2            2
             annual capital budget.                         Collins Street (IH20 to Mayfield Road)       8
                                                            Calender Road (Harris Road to Eden Road)     2
             The projects shown to the right were expected to   Harris Road (Calender Road to Cooper Street)   3
             bid or begin construction during FY19. The projects   Collins Street (Pioneer Parkway to Park Row Drive)   6
             listed below include updated information about   Avenue H (SH360 to Great Southwest Parkway)   4
             carry‐over projects from previous years.  Project
                                                            2019 CDBG Residential Rebuild (Kimberly Drive)   1
             milestones listed in the table will be updated as

             they occur during the year.

             Update:
             The Timberlake Dr. (E. City limits to E. Pioneer

             Parkway) project completed construction in
                                                         The final design for Harris Road has been delayed due to
             September.
                                                         environmental issues related to the U.S. Army Corps of Engineers’
             The bid phase for the Calender Road project has   permitting.
             been delayed due to real estate negotiations. Not
             only is the property important for the project, it is
             at a crucial location for franchise utility relocation
             efforts.

                      Roadway Capital Improvement Project     Estimated   Actual Bid   Estimated   Actual
                                                               Bid Date    Date     Completion   Completion
                 Abram Street (Cooper to Collins)            Feb. 2018   Feb. 2018   Mar. 2020
                 Timberlake Drive (Pioneer Pkwy to Park Row Drive)   Feb. 2018   Feb. 2018   Apr. 2019   Sept. 2019
                 2017 Residential Rebuild; Phase 1           Mar. 2018   Mar. 2018   May 2019    May 2019
                 2018 CDBG Residential Rebuild (Belvedere)   June 2018   June 2018   Jan. 2019   May 2019
                 Eden Road (US287 to Calender)               June 2018   Aug. 2019   July 2021
                 2017 Residential Rebuild Phase 2            Mar. 2019   Feb. 2019   Mar. 2020
                 2019 CDBG Residential Rebuild               Mar. 2019   Feb. 2019   Nov. 2019
                 Collins Street (IH20 to Mayfield Road)      Apr. 2019   Feb. 2019   Dec. 2019
                 Calender Road (Harris Road to Eden Road)    Apr. 2019
                 Harris Road (Calender Road to Cooper Street)   May 2019
                 Collins Street (Pioneer Parkway to Park Row Drive)   June 2019   July 2019   May 2021
                 Avenue H (SH360 to Great Southwest Parkway)   May 2019   Sept. 2019   June 2021
                 2019 CDBG Residential Rebuild (Kimberly Drive)   June 2019   May 2019   Mar. 2020







                                                             26
