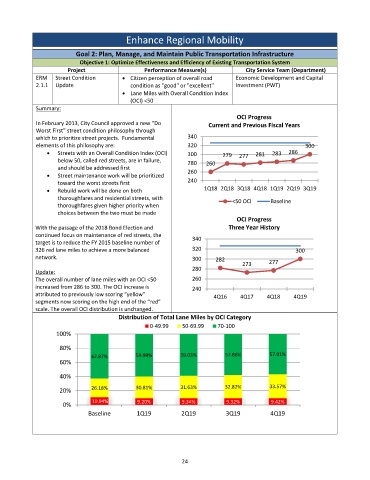

Enhance Regional Mobility

                          Goal 2: Plan, Manage, and Maintain Public Transportation Infrastructure
                           Objective 1: Optimize Effectiveness and Efficiency of Existing Transportation System
                       Project                   Performance Measure(s)           City Service Team (Department)
             ERM   Street Condition       Citizen perception of overall road  Economic Development and Capital
             2.1.1  Update                  condition as "good" or "excellent"  Investment (PWT)
                                          Lane Miles with Overall Condition Index
                                            (OCI) <50
             Summary:
                                                                               OCI Progress
             In February 2013, City Council approved a new “Do        Current and Previous Fiscal Years
             Worst First” street condition philosophy through
             which to prioritize street projects.  Fundamental   340
             elements of this philosophy are:                  320                                    300
                   Streets with an Overall Condition Index (OCI)  300     279  277   281  283   286
                    below 50, called red streets, are in failure,   280  260
                    and should be addressed first
                   Street maintenance work will be prioritized  260
                                                               240
                    toward the worst streets first
                   Rebuild work will be done on both                1Q18 2Q18 3Q18 4Q18 1Q19 2Q19 3Q19
                    thoroughfares and residential streets, with
                                                                              <50 OCI      Baseline
                    thoroughfares given higher priority when
                    choices between the two must be made
                                                                               OCI Progress
             With the passage of the 2018 Bond Election and                  Three Year History
             continued focus on maintenance of red streets, the
                                                                 340
             target is to reduce the FY 2015 baseline number of
             326 red lane miles to achieve a more balanced       320                               300
             network.                                            300    282
                                                                                 273      277
                                                                 280
             Update:
             The overall number of lane miles with an OCI <50    260
             increased from 286 to 300. The OCI increase is      240
             attributed to previously low scoring “yellow”              4Q16     4Q17    4Q18     4Q19
             segments now scoring on the high end of the “red”
             scale. The overall OCI distribution is unchanged.
                                        Distribution of Total Lane Miles by OCI Category
                                                   0‐49.99   50‐69.99    70‐100
                    100%

                     80%
                               62.87%         59.99%         59.03%        57.86%         57.01%
                     60%

                     40%

                               26.18%         30.81%         31.63%        32.82%         33.57%
                     20%
                               10.94%         9.20%          9.34%          9.32%          9.42%
                      0%
                              Baseline        1Q19           2Q19           3Q19          4Q19
