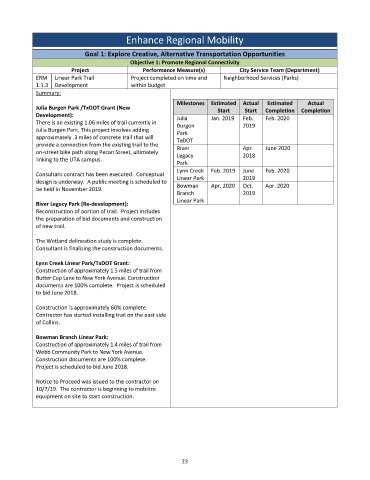

Page 369 - Microsoft Word - FY 2020 Adopted Budget Document
P. 369
Enhance Regional Mobility
Goal 1: Explore Creative, Alternative Transportation Opportunities
Objective 1: Promote Regional Connectivity
Project Performance Measure(s) City Service Team (Department)
ERM Linear Park Trail Project completed on time and Neighborhood Services (Parks)
1.1.3 Development within budget
Summary:
Milestones Estimated Actual Estimated Actual
Julia Burgen Park /TxDOT Grant (New Start Start Completion Completion
Development):
Julia Jan. 2019 Feb. Feb. 2020
There is an existing 1.06 miles of trail currently in
Burgen 2019
Julia Burgen Park. This project involves adding Park
approximately .3 miles of concrete trail that will TxDOT
provide a connection from the existing trail to the River A p r . June 2020
on‐street bike path along Pecan Street, ultimately Legacy 2018
linking to the UTA campus.
Park
Lynn Creek Feb. 2019 June Feb. 2020
Consultant contract has been executed. Conceptual Linear Park 2019
design is underway. A public meeting is scheduled to
be held in November 2019. Bowman Apr. 2020 Oct. Apr. 2020
Branch
2019
Linear Park
River Legacy Park (Re‐development):
Reconstruction of portion of trail. Project includes
the preparation of bid documents and construction
of new trail.
The Wetland delineation study is complete.
Consultant is finalizing the construction documents.
Lynn Creek Linear Park/TxDOT Grant:
Construction of approximately 1.5 miles of trail from
Butter Cup Lane to New York Avenue. Construction
documents are 100% complete. Project is scheduled
to bid June 2018.
Construction is approximately 60% complete.
Contractor has started installing trail on the east side
of Collins.
Bowman Branch Linear Park:
Construction of approximately 1.4 miles of trail from
Webb Community Park to New York Avenue.
Construction documents are 100% complete.
Project is scheduled to bid June 2018.
Notice to Proceed was issued to the contractor on
10/7/19. The contractor is beginning to mobilize
equipment on site to start construction.
23
