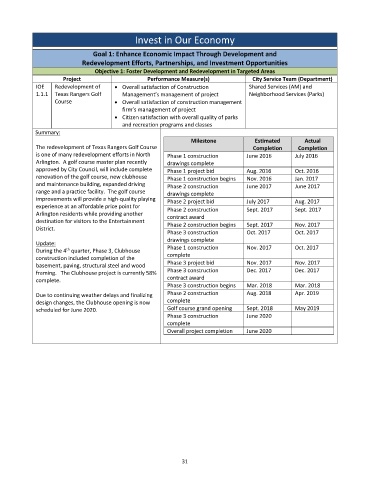

Invest in Our Economy


                                Goal 1: Enhance Economic Impact Through Development and
                            Redevelopment Efforts, Partnerships, and Investment Opportunities
                                Objective 1: Foster Development and Redevelopment in Targeted Areas
                      Project                     Performance Measure(s)             City Service Team (Department)
             IOE   Redevelopment of      Overall satisfaction of Construction     Shared Services (AM) and
             1.1.1  Texas Rangers Golf   Management’s management of project        Neighborhood Services (Parks)
                   Course                Overall satisfaction of construction management
                                         firm’s management of project
                                         Citizen satisfaction with overall quality of parks
                                         and recreation programs and classes
             Summary:
                                                                Milestone            Estimated        Actual
             The redevelopment of Texas Rangers Golf Course                          Completion     Completion
             is one of many redevelopment efforts in North   Phase 1 construction   June 2016      July 2016
             Arlington.  A golf course master plan recently   drawings complete
             approved by City Council, will include complete   Phase 1 project bid   Aug. 2016     Oct. 2016
             renovation of the golf course, new clubhouse   Phase 1 construction begins   Nov. 2016   Jan. 2017
             and maintenance building, expanded driving   Phase 2 construction     June 2017       June 2017
             range and a practice facility.  The golf course   drawings complete
             improvements will provide a high‐quality playing   Phase 2 project bid    July 2017   Aug. 2017
             experience at an affordable price point for   Phase 2 construction    Sept. 2017      Sept. 2017
             Arlington residents while providing another
                                                        contract award
             destination for visitors to the Entertainment   Phase 2 construction begins   Sept. 2017   Nov. 2017
             District.                                  Phase 3 construction       Oct. 2017       Oct. 2017
                                                        drawings complete
             Update:
                       th
             During the 4  quarter, Phase 3, Clubhouse   Phase 1 construction      Nov. 2017       Oct. 2017
             construction included completion of the    complete
                                                        Phase 3 project bid        Nov. 2017       Nov. 2017
             basement, paving, structural steel and wood
                                                        Phase 3 construction       Dec. 2017       Dec. 2017
             framing.   The Clubhouse project is currently 58%
                                                        contract award
             complete.
                                                        Phase 3 construction begins   Mar. 2018    Mar. 2018
             Due to continuing weather delays and finalizing   Phase 2 construction   Aug. 2018    Apr. 2019
             design changes, the Clubhouse opening is now   complete
             scheduled for June 2020.                   Golf course grand opening   Sept. 2018     May 2019
                                                        Phase 3 construction       June 2020
                                                        complete
                                                        Overall project completion   June 2020
