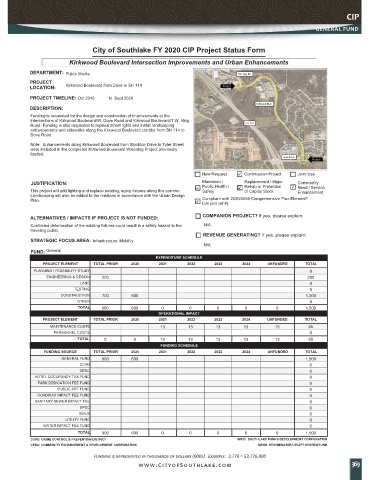

                                City of Southlake FY 2020 CIP Project Status Form

                        Kirkwood Boulevard Intersection Improvements and Urban Enhancements

           DEPARTMENT: Public Works
           PROJECT
           LOCATION:   Kirkwood Boulevard from Dove to SH 114

           PROJECT TIMELINE: Oct 2016  to  Sept 2020
           DESCRIPTION:
           Funding is requested for the design and construction of improvements at the
           intersections of Kirkwood Boulevard/W. Dove Road and Kirkwood Boulevard/T.W. King
           Road. Funding is also requested to replace street lights and install landscaping
           enhancements and sidewalks along the Kirkwood Boulevard corridor from SH 114 to
           Dove Road.
           Note: Enhancements along Kirkwood Boulevard from Stockton Drive to Tyler Street
           were included in the completed Kirkwood Boulevard Widening Project previously
           funded.


                                                                    New Request     Continuation Project  Joint Use
           JUSTIFICATION:                                           Mandated /    Replacement / Major   Community
                                                                    Public Health /
                                                                                  Rehab or Protection
           This project will add lighting and replace existing, aging fixtures along this corridor.     Safety     of Capital Stock     Need / Service
                                                                                                   Enhancement
           Landscaping will also be added to the medians in accordance with the Urban Design
           Plan.                                                     Compliant with 2030/2035 Comprehensive Plan Element?
                                                                    List (incl ref #):
           ALTERNATIVES / IMPACTS IF PROJECT IS NOT FUNDED:         COMPANION PROJECT? If yes, please explain:
           Continued deterioration of the existing fixtures could result in a safety hazard to the  N/A
           traveling public.
                                                                    REVENUE GENERATING? If yes, please explain:
           STRATEGIC FOCUS AREA: Infrastructure, Mobility
                                                                    N/A
           FUND:  General
                                                     EXPENDITURE SCHEDULE
               PROJECT ELEMENT  TOTAL PRIOR  2020     2021     2022     2023     2024     UNFUNDED    TOTAL
            PLANNING / FEASIBILITY STUDY                                                               0
                ENGINEERING & DESIGN  200                                                              200
                            LAND                                                                       0
                          TESTING                                                                      0
                     CONSTRUCTION  700      600                                                       1,300
                           OTHER                                                                       0
                           TOTAL   900      600       0         0        0        0         0         1,500
                                                     OPERATIONAL IMPACT
               PROJECT ELEMENT  TOTAL PRIOR  2020     2021     2022     2023     2024    UNFUNDED     TOTAL
                  MAINTENANCE COSTS                   13       13       13        13        13         65
                   PERSONNEL COSTS                                                                     0
                           TOTAL    0        0        13       13       13        13        13         65
                                                      FUNDING SCHEDULE
                FUNDING SOURCE  TOTAL PRIOR  2020     2021     2022     2023     2024     UNFUNDED    TOTAL
                     GENERAL FUND  900      600                                                       1,500
                           CCPD                                                                        0
                           CEDC                                                                        0
             HOTEL OCCUPANCY TAX FUND                                                                  0
              PARK DEDICATION FEE FUND                                                                 0
                    PUBLIC ART FUND                                                                    0
             ROADWAY IMPACT FEE FUND                                                                   0
             SANITARY SEWER IMPACT FEE                                                                 0
                           SPDC                                                                        0
                           SWUS                                                                        0
                       UTILITY FUND                                                                    0
               WATER IMPACT FEE FUND                                                                   0
                           TOTAL   900      600       0         0        0        0         0         1,500
           CCPD: CRIME CONTROL & PREVENTION DISTRICT                            SPDC: SOUTHLAKE PARKS DEVELOPMENT CORPORATION
           CEDC: COMMUNITY ENHANCEMENT & DEVELOPMENT CORPORATION                      SWUS: STORMWATER UTILITY SYSTEM FUND
                                Funding is represented in thousands of dollars (000s).  Example:  3,776 = $3,776,000
                                               www.CityofSouthlake.com                                               369
