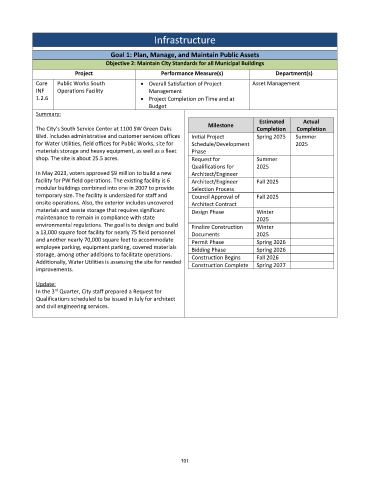

Infrastructure
Goal 1: Plan, Manage, and Maintain Public Assets
Objective 2: Maintain City Standards for all Municipal Buildings
Project Performance Measure(s) Department(s)
Core Public Works South Overall Satisfaction of Project Asset Management
INF Operations Facility Management
1.2.6 Project Completion on Time and at
Budget
Summary:
Milestone Estimated Actual
The City’s South Service Center at 1100 SW Green Oaks Completion Completion
Blvd. includes administrative and customer services offices Initial Project Spring 2025 Summer
for Water Utilities, field offices for Public Works, site for Schedule/Development 2025
materials storage and heavy equipment, as well as a fleet Phase
shop. The site is about 25.5 acres. Request for Summer
Qualifications for 2025
In May 2023, voters approved $9 million to build a new Architect/Engineer
facility for PW field operations. The existing facility is 6 Architect/Engineer Fall 2025
modular buildings combined into one in 2007 to provide Selection Process
temporary size. The facility is undersized for staff and Council Approval of Fall 2025
onsite operations. Also, the exterior includes uncovered Architect Contract
materials and waste storage that requires significant Design Phase Winter
maintenance to remain in compliance with state 2025
environmental regulations. The goal is to design and build Finalize Construction Winter
a 13,000 square foot facility for nearly 75 field personnel Documents 2025
and another nearly 70,000 square feet to accommodate Permit Phase Spring 2026
employee parking, equipment parking, covered materials
Bidding Phase Spring 2026
storage, among other additions to facilitate operations. Construction Begins Fall 2026
Additionally, Water Utilities is assessing the site for needed Construction Complete Spring 2027
improvements.
Update:
rd
In the 3 Quarter, City staff prepared a Request for
Qualifications scheduled to be issued in July for architect
and civil engineering services.
