CITY OF BEDFORD -   FY 19-20 CAPITAL PROJECT SUMMARY

     PROJECT:      Streets               PROJECT TYPE: SIEDC 4B Corp.         FUNDING SOURCE(S):
     PROJECT TITLE: Cheek Sparger Road Signal Installation and Roadway Improvements SIEDC               $        513,000

      PROJECT DESCRIPTION:                                                                              $
      This project is for the installation of a traffic signal at the intersection of Cheeksparger      $
      Road and Heritage Avenue. The project also includes the construction of an additional
      forward through lane to facilitate efficient and effective management of vehicle traffic          $
      through the intersection. The roadway improvement will add a left turn lane to turn
                                                                                                        $
      onto Heritage Avenue, two eastbound forward lanes, a westbound forward lane and a
      left turn lane to turn onto Woodpark Lane. The traffic signal installation is a joint   TOTAL FUNDED $     513,000
      project between Tarrant County and the cities of Colleyville, Euless, and Bedford.
                                                                                             UNFUNDED $

                                                                                          PROJECT TOTAL $        513,000
           PROJECT COSTS        Thru                                                               FY 2025 to
          (amounts in 000s)    09/2019    FY 2020     FY 2021    FY 2022     FY 2023    FY 2024   Completion    Total
     Design                      63,000           -          -           -           -          -           -     63,000
     Land/Right-of-Way                -           -          -           -           -          -           -          -
     Construction                     -     450,000          -           -           -          -           -    450,000

     Landscaping                      -           -          -           -           -          -           -          -
     Equipment & Furnishings          -           -          -           -           -          -           -          -
     Other                            -           -          -           -           -          -           -          -
           TOTAL COSTS            63,000     450,000          -          -           -          -           -     513,000
          SOURCE OF FUNDS       Thru                                                               FY 2025 to
          (amounts in 000s)    09/2019    FY 2020     FY 2021    FY 2022     FY 2023    FY 2024   Completion    Total
     Current Funds               63,000     450,000          -           -           -          -           -    513,000

     GO Bonds Issued                  -           -          -           -           -          -           -          -
     GO Bonds Unissued                -           -          -           -           -          -           -          -
     Certificates of Obligation       -           -          -           -           -          -           -          -
     Other                            -           -          -           -           -          -           -          -

     Unfunded                         -           -          -           -           -          -           -          -
           TOTAL COSTS            63,000     450,000          -          -           -          -           -     513,000
                        OPERATING BUDGET IMPACT

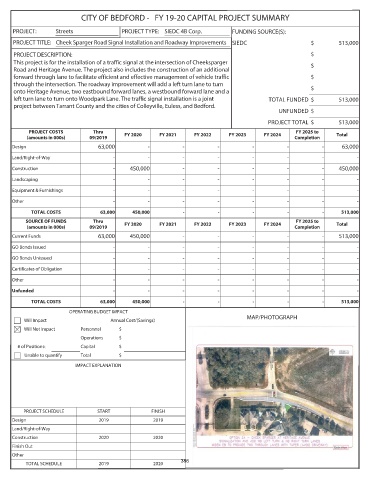

                                                                                   MAP/PHOTOGRAPH
         Will Impact                  Annual Cost/(Savings)
         Will Not Impact    Personnel   $
                            Operations  $
       # of Positions:      Capital     $
         Unable to quantify  Total      $
                          IMPACT EXPLANATION







         PROJECT SCHEDULE        START             FINISH
     Design                       2019              2019
     Land/Right-of-Way
     Construction                 2020              2020
     Finish Out
     Other
                                                             386
          TOTAL SCHEDULE          2019              2020
