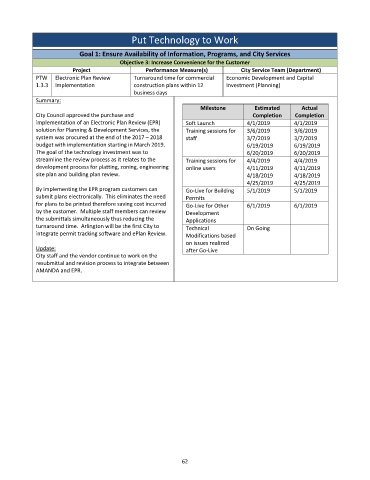

Put Technology to Work


                           Goal 1: Ensure Availability of Information, Programs, and City Services
                                         Objective 3: Increase Convenience for the Customer
                         Project                 Performance Measure(s)          City Service Team (Department)
             PTW   Electronic Plan Review    Turnaround time for commercial   Economic Development and Capital
             1.3.3  Implementation           construction plans within 12   Investment (Planning)
                                             business days
             Summary:
                                                                   Milestone         Estimated       Actual
             City Council approved the purchase and                                  Completion    Completion
             implementation of an Electronic Plan Review (EPR)   Soft Launch       4/1/2019       4/1/2019
             solution for Planning & Development Services, the   Training sessions for   3/6/2019   3/6/2019
             system was procured at the end of the 2017 – 2018   staff             3/7/2019       3/7/2019
             budget with implementation starting in March 2019.                    6/19/2019      6/19/2019
             The goal of the technology investment was to                          6/20/2019      6/20/2019
             streamline the review process as it relates to the   Training sessions for   4/4/2019   4/4/2019
             development process for platting, zoning, engineering   online users   4/11/2019     4/11/2019
             site plan and building plan review.                                   4/18/2019      4/18/2019
                                                                                   4/25/2019      4/25/2019
             By implementing the EPR program customers can     Go‐Live for Building   5/1/2019    5/1/2019
             submit plans electronically.  This eliminates the need   Permits
             for plans to be printed therefore saving cost incurred   Go‐Live for Other   6/1/2019   6/1/2019
             by the customer.  Multiple staff members can review   Development
             the submittals simultaneously thus reducing the   Applications
             turnaround time.  Arlington will be the first City to   Technical     On Going
             integrate permit tracking software and ePlan Review.   Modifications based
                                                               on issues realized
             Update:                                           after Go‐Live
             City staff and the vendor continue to work on the
             resubmittal and revision process to integrate between

             AMANDA and EPR.
