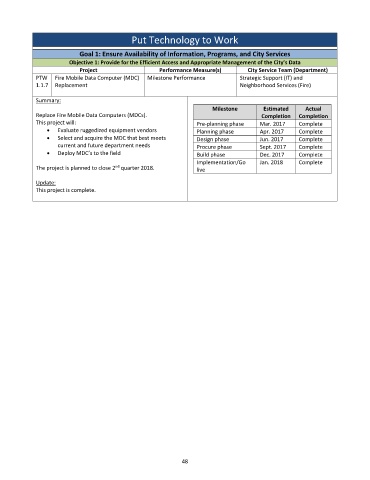

Page 379 - City of Arlington FY19 Adopted Operating Budget
P. 379
Put Technology to Work
Goal 1: Ensure Availability of Information, Programs, and City Services
Objective 1: Provide for the Efficient Access and Appropriate Management of the City’s Data
Project Performance Measure(s) City Service Team (Department)
PTW Fire Mobile Data Computer (MDC) Milestone Performance Strategic Support (IT) and
1.1.7 Replacement Neighborhood Services (Fire)
Summary:
Milestone Estimated Actual
Replace Fire Mobile Data Computers (MDCs). Completion Completion
This project will: Pre‐planning phase Mar. 2017 Complete
Evaluate ruggedized equipment vendors Planning phase Apr. 2017 Complete
Select and acquire the MDC that best meets Design phase Jun. 2017 Complete
current and future department needs Procure phase Sept. 2017 Complete
Deploy MDC’s to the field Build phase Dec. 2017 Complete
Implementation/Go Jan. 2018 Complete
nd
The project is planned to close 2 quarter 2018. live
Update:
This project is complete.
