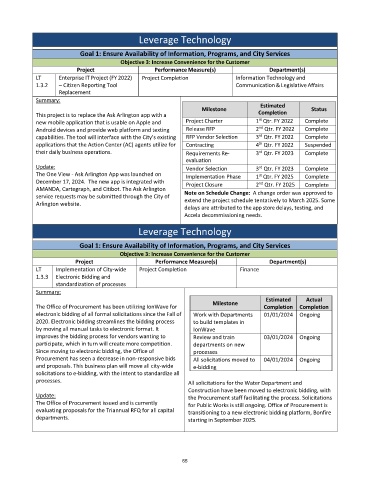

Leverage Technology

                            Goal 1: Ensure Availability of Information, Programs, and City Services
                                         Objective 3: Increase Convenience for the Customer
                          Project                   Performance Measure(s)                Department(s)
             LT      Enterprise IT Project (FY 2022)   Project Completion      Information Technology and
             1.3.2   – Citizen Reporting Tool                                  Communication & Legislative Affairs
                     Replacement
             Summary:
                                                                                       Estimated
                                                                    Milestone                           Status
             This project is to replace the Ask Arlington app with a                  Completion
                                                                                       st
             new mobile application that is usable on Apple and   Project Charter     1  Qtr. FY 2022   Complete
                                                                                       nd
             Android devices and provide web platform and texting   Release RFP       2  Qtr. FY 2022   Complete
                                                                                       rd
             capabilities. The tool will interface with the City’s existing   RFP Vendor Selection   3  Qtr. FY 2022   Complete
             applications that the Action Center (AC) agents utilize for   Contracting   4  Qtr. FY 2022   Suspended
                                                                                       th
             their daily business operations.                  Requirements Re‐       3  Qtr. FY 2023   Complete
                                                                                       rd
                                                               evaluation
             Update:                                           Vendor Selection       3  Qtr. FY 2023   Complete
                                                                                       rd
             The One View - Ask Arlington App was launched on   Implementation Phase   1  Qtr. FY 2025   Complete
                                                                                       st
             December 17, 2024.  The new app is integrated with   Project Closure     2  Qtr. FY 2025   Complete
                                                                                       nd
             AMANDA, Cartegraph, and Citibot. The Ask Arlington
                                                              Note on Schedule Change:  A change order was approved to
             service requests may be submitted through the City of   extend the project schedule tentatively to March 2025. Some
             Arlington website.
                                                              delays are attributed to the app store delays, testing, and
                                                              Accela decommissioning needs.
                                               Leverage Technology

                           Goal 1: Ensure Availability of Information, Programs, and City Services
                                         Objective 3: Increase Convenience for the Customer
                          Project                   Performance Measure(s)                Department(s)
             LT    Implementation of City-wide   Project Completion             Finance
             1.3.3   Electronic Bidding and
                   standardization of processes
             Summary:
                                                                                         Estimated    Actual
                                                                       Milestone
             The Office of Procurement has been utilizing IonWave for                   Completion  Completion
             electronic bidding of all formal solicitations since the Fall of   Work with Departments   01/01/2024  Ongoing
             2020. Electronic bidding streamlines the bidding process   to build templates in
             by moving all manual tasks to electronic format. It   IonWave
             improves the bidding process for vendors wanting to   Review and train     03/01/2024  Ongoing
             participate, which in turn will create more competition.   departments on new
             Since moving to electronic bidding, the Office of   processes
             Procurement has seen a decrease in non-responsive bids   All solicitations moved to   04/01/2024  Ongoing
             and proposals. This business plan will move all city-wide   e-bidding
             solicitations to e-bidding, with the intent to standardize all
             processes.                                        All solicitations for the Water Department and
                                                               Construction have been moved to electronic bidding, with
             Update:                                           the Procurement staff facilitating the process. Solicitations
             The Office of Procurement issued and is currently   for Public Works is still ongoing. Office of Procurement is
             evaluating proposals for the Triannual RFQ for all capital   transitioning to a new electronic bidding platform, Bonfire
             departments.
                                                               starting in September 2025.
