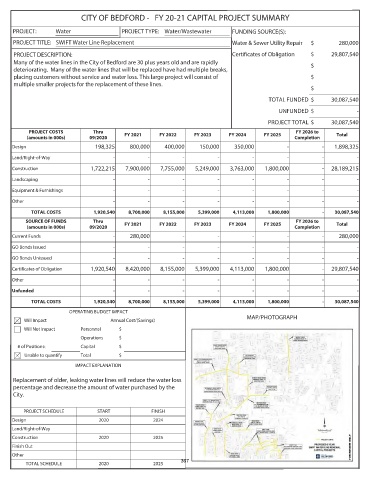

CITY OF BEDFORD -   FY 20-21 CAPITAL PROJECT SUMMARY

     PROJECT:      Water                 PROJECT TYPE: Water/Wastewater       FUNDING SOURCE(S):
     PROJECT TITLE: SWIFT Water Line Replacement                              Water & Sewer Utility Repair  $    280,000

      PROJECT DESCRIPTION:                                                    Certificates of Obligation  $    29,807,540
      Many of the water lines in the City of Bedford are 30 plus years old and are rapidly              $
      deteriorating.  Many of the water lines that will be replaced have had multiple breaks,
      placing customers without service and water loss. This large project will consist of              $
      multiple smaller projects for the replacement of these lines.
                                                                                                        $
                                                                                          TOTAL FUNDED $       30,087,540
                                                                                             UNFUNDED $                -

                                                                                          PROJECT TOTAL $      30,087,540
           PROJECT COSTS        Thru                                                               FY 2026 to
          (amounts in 000s)    09/2020    FY 2021     FY 2022    FY 2023     FY 2024    FY 2025   Completion    Total
     Design                     198,325     800,000     400,000    150,000     350,000          -           -   1,898,325
     Land/Right-of-Way                -           -          -           -           -          -           -          -
     Construction              1,722,215   7,900,000  7,755,000   5,249,000  3,763,000   1,800,000          -  28,189,215

     Landscaping                      -           -          -           -           -          -           -          -
     Equipment & Furnishings          -           -          -           -           -          -           -          -
     Other                            -           -          -           -           -          -           -          -
           TOTAL COSTS          1,920,540   8,700,000  8,155,000   5,399,000  4,113,000   1,800,000         -   30,087,540
          SOURCE OF FUNDS       Thru                                                               FY 2026 to
          (amounts in 000s)    09/2020    FY 2021     FY 2022    FY 2023     FY 2024    FY 2025   Completion    Total
     Current Funds                    -     280,000          -           -           -          -           -    280,000

     GO Bonds Issued                  -           -          -           -           -          -           -          -
     GO Bonds Unissued                -           -          -           -           -          -           -          -
     Certificates of Obligation  1,920,540  8,420,000  8,155,000  5,399,000  4,113,000   1,800,000          -  29,807,540
     Other                            -           -          -           -           -          -           -          -

     Unfunded                         -           -          -           -           -          -           -          -
           TOTAL COSTS          1,920,540   8,700,000  8,155,000   5,399,000  4,113,000   1,800,000         -   30,087,540
                        OPERATING BUDGET IMPACT
                                                                                   MAP/PHOTOGRAPH
         Will Impact                  Annual Cost/(Savings)
         Will Not Impact    Personnel   $
                            Operations  $
       # of Positions:      Capital     $
         Unable to quantify  Total      $
                          IMPACT EXPLANATION

     Replacement of older, leaking water lines will reduce the water loss
     percentage and decrease the amount of water purchased by the
     City.

         PROJECT SCHEDULE        START             FINISH
     Design                       2020              2024
     Land/Right-of-Way
     Construction                 2020              2025
     Finish Out
     Other
                                                             367
          TOTAL SCHEDULE          2020              2025
