Business Plan




                             Preserve Financial Stability and Resilience

                                        Build a Sustainable, Talented Workforce

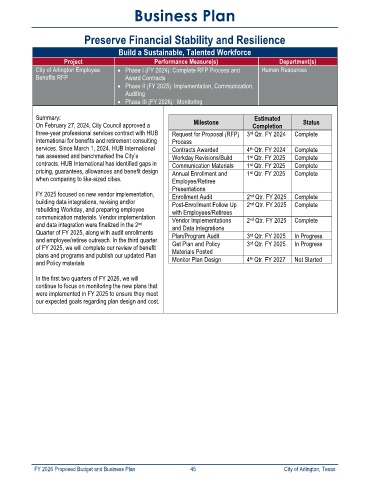

                      Project                       Performance Measure(s)                   Department(s)
             City of Arlington Employee   •  Phase I (FY 2024): Complete RFP Process and   Human Resources
             Benefits RFP                 Award Contracts
                                        •  Phase II (FY 2025): Implementation, Communication,
                                          Auditing
                                        •  Phase III (FY 2026):  Monitoring

             Summary:                                                                Estimated
             On February 27, 2024, City Council approved a       Milestone           Completion      Status
             three-year professional services contract with HUB   Request for Proposal (RFP)  3  Qtr. FY 2024   Complete
                                                                                    rd
             International for benefits and retirement consulting   Process
             services. Since March 1, 2024, HUB International   Contracts Awarded   4  Qtr. FY 2024   Complete
                                                                                    th
             has assessed and benchmarked the City’s      Workday Revisions/Build   1  Qtr. FY 2025   Complete
                                                                                    st
             contracts. HUB International has identified gaps in   Communication Materials   1  Qtr. FY 2025   Complete
                                                                                    st
             pricing, guarantees, allowances and benefit design   Annual Enrollment and   1  Qtr. FY 2025   Complete
                                                                                    st
             when comparing to like-sized cities.         Employee/Retiree
                                                          Presentations
             FY 2025 focused on new vendor implementation,   Enrollment Audit      2  Qtr. FY 2025  Complete
                                                                                    nd
             building data integrations, revising and/or   Post-Enrollment Follow Up   2  Qtr. FY 2025  Complete
                                                                                    nd
             rebuilding Workday, and preparing employee   with Employees/Retirees
             communication materials. Vendor implementation   Vendor Implementations   2  Qtr. FY 2025  Complete
                                                                                    nd
             and data integration were finalized in the 2    and Data Integrations
                                               nd
             Quarter of FY 2025, along with audit enrollments   Plan/Program Audit   3  Qtr. FY 2025   In Progress
                                                                                    rd
             and employee/retiree outreach. In the third quarter   Get Plan and Policy   3  Qtr. FY 2025   In Progress
                                                                                    rd
             of FY 2025, we will complete our review of benefit   Materials Posted
             plans and programs and publish our updated Plan                        th
             and Policy materials                         Monitor Plan Design      4  Qtr. FY 2027   Not Started

             In the first two quarters of FY 2026, we will
             continue to focus on monitoring the new plans that
             were implemented in FY 2025 to ensure they meet
             our expected goals regarding plan design and cost.
