Page 477 - FY 2009 Proposed Budget
P. 477

Public Safety


                             Goal 2: Mitigate Flood Risks and Protect Stormwater Infrastructure
                                        Objective 1: Plan and Implement Stormwater Projects
                       Project                     Performance Measure(s)           City Service Team (Department)
             Core   Stormwater Projects   Implement projects that mitigate flooding   Economic Development and
             PS                          concerns                                  Capital Investment (PWT)
             2.1.1
             Summary:
             Stormwater Projects are funded through the Stormwater
             Utility Fee and are included in the annual capital budget. The
             projects listed below are expected to begin or complete
             construction during FY 2020. Project milestones listed in the
             table will be updated as they occur during the year.

             Update:
             The Matthews Court Drainage Improvements Phase 1 and 2
             construction, which began in June of 2020, is proceeding on
             schedule.  The improvements in Randol Mill Park and along
             Randol Mill Road are scheduled to be completed December of
             2020.

             Kee Branch Trib 4 is being constructed in two phases.
             Construction of the segment in Deaver Park (Phase 1) will
             begin in November of 2020 while easements are acquired in
             the segment between Bradley Lane and Andalusia Trail (Phase
             2).

             The Harvest Hills project is split into a channel project (Phase
             1) and a neighborhood improvements project (Phase 2). Phase
             1 is in the final design phase and easement acquisitions will
             begin in FY 2021.  Phase 2 design will also begin in FY 2021.
                                                                  The Country Club Channel and Drainage Improvements

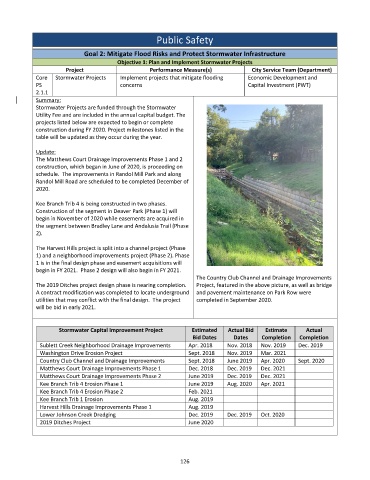

             The 2019 Ditches project design phase is nearing completion.    Project, featured in the above picture, as well as bridge
             A contract modification was completed to locate underground  and pavement maintenance on Park Row were
             utilities that may conflict with the final design.  The project   completed in September 2020.
             will be bid in early 2021.


                     Stormwater Capital Improvement Project      Estimated   Actual Bid   Estimate    Actual
                                                                 Bid Dates    Dates     Completion   Completion
              Sublett Creek Neighborhood Drainage Improvements   Apr. 2018   Nov. 2018   Nov. 2019   Dec. 2019
              Washington Drive Erosion Project                 Sept. 2018   Nov. 2019   Mar. 2021
              Country Club Channel and Drainage Improvements   Sept. 2018   June 2019   Apr. 2020   Sept. 2020
              Matthews Court Drainage Improvements Phase 1     Dec. 2018    Dec. 2019   Dec. 2021
              Matthews Court Drainage Improvements Phase 2     June 2019    Dec. 2019   Dec. 2021
              Kee Branch Trib 4 Erosion Phase 1                June 2019    Aug. 2020   Apr. 2021
              Kee Branch Trib 4 Erosion Phase 2                Feb. 2021
              Kee Branch Trib 1 Erosion                        Aug. 2019
              Harvest Hills Drainage Improvements Phase 1      Aug. 2019
              Lower Johnson Creek Dredging                     Dec. 2019    Dec. 2019   Oct. 2020
              2019 Ditches Project                             June 2020
