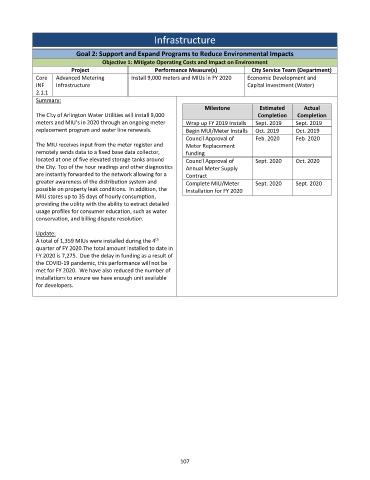

Infrastructure
Goal 2: Support and Expand Programs to Reduce Environmental Impacts
Objective 1: Mitigate Operating Costs and Impact on Environment
Project Performance Measure(s) City Service Team (Department)
Core Advanced Metering Install 9,000 meters and MIUs in FY 2020 Economic Development and
INF Infrastructure Capital Investment (Water)
2.1.1
Summary:
Milestone Estimated Actual
The City of Arlington Water Utilities will install 9,000 Completion Completion
meters and MIU’s in 2020 through an ongoing meter Wrap up FY 2019 Installs Sept. 2019 Sept. 2019
replacement program and water line renewals. Begin MUI/Meter Installs Oct. 2019 Oct. 2019
Council Approval of Feb. 2020 Feb. 2020
The MIU receives input from the meter register and Meter Replacement
remotely sends data to a fixed base data collector, funding
located at one of five elevated storage tanks around Council Approval of Sept. 2020 Oct. 2020
the City. Top of the hour readings and other diagnostics Annual Meter Supply
are instantly forwarded to the network allowing for a Contract
greater awareness of the distribution system and Complete MIU/Meter Sept. 2020 Sept. 2020
possible on property leak conditions. In addition, the Installation for FY 2020
MIU stores up to 35 days of hourly consumption,
providing the utility with the ability to extract detailed
usage profiles for consumer education, such as water
conservation, and billing dispute resolution.
Update:
th
A total of 1,359 MIUs were installed during the 4
quarter of FY 2020.The total amount installed to date in
FY 2020 is 7,275. Due the delay in funding as a result of
the COVID‐19 pandemic, this performance will not be
met for FY 2020. We have also reduced the number of
installations to ensure we have enough unit available
for developers.
