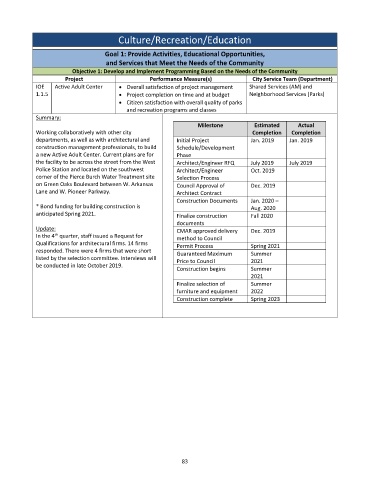

Culture/Recreation/Education


                                    Goal 1: Provide Activities, Educational Opportunities,
                                    and Services that Meet the Needs of the Community
                         Objective 1: Develop and Implement Programming Based on the Needs of the Community
                       Project                     Performance Measure(s)            City Service Team (Department)
             IOE   Active Adult Center     Overall satisfaction of project management   Shared Services (AM) and
             1.1.5                        Project completion on time and at budget   Neighborhood Services (Parks)
                                          Citizen satisfaction with overall quality of parks
                                           and recreation programs and classes
             Summary:
                                                                  Milestone          Estimated      Actual
             Working collaboratively with other city                                 Completion   Completion
             departments, as well as with architectural and   Initial Project       Jan. 2019    Jan. 2019
             construction management professionals, to build   Schedule/Development
             a new Active Adult Center. Current plans are for   Phase
             the facility to be across the street from the West   Architect/Engineer RFQ    July 2019   July 2019
             Police Station and located on the southwest   Architect/Engineer       Oct. 2019
             corner of the Pierce Burch Water Treatment site   Selection Process
             on Green Oaks Boulevard between W. Arkansas   Council Approval of      Dec. 2019
             Lane and W. Pioneer Parkway.                  Architect Contract
                                                           Construction Documents   Jan. 2020 –
             * Bond funding for building construction is                            Aug. 2020
             anticipated Spring 2021.                      Finalize construction    Fall 2020
                                                           documents
             Update:                                       CMAR approved delivery   Dec. 2019
                   th
             In the 4  quarter, staff issued a Request for
                                                           method to Council
             Qualifications for architectural firms. 14 firms   Permit Process      Spring 2021
             responded. There were 4 firms that were short   Guaranteed Maximum     Summer
             listed by the selection committee. Interviews will
                                                           Price to Council         2021
             be conducted in late October 2019.
                                                           Construction begins      Summer
                                                                                    2021
                                                           Finalize selection of    Summer
                                                           furniture and equipment   2022
                                                           Construction complete    Spring 2023




























                                                             83
