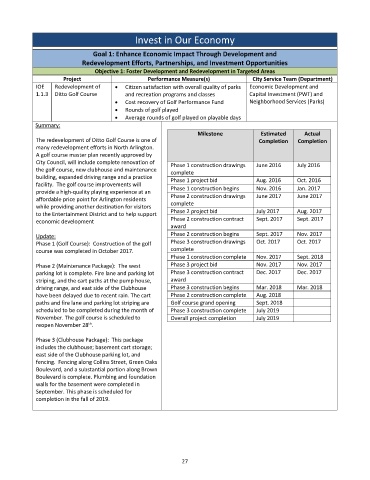

Page 358 - City of Arlington FY19 Adopted Operating Budget
P. 358
Invest in Our Economy
Goal 1: Enhance Economic Impact Through Development and
Redevelopment Efforts, Partnerships, and Investment Opportunities
Objective 1: Foster Development and Redevelopment in Targeted Areas
Project Performance Measure(s) City Service Team (Department)
IOE Redevelopment of Citizen satisfaction with overall quality of parks Economic Development and
1.1.3 Ditto Golf Course and recreation programs and classes Capital Investment (PWT) and
Cost recovery of Golf Performance Fund Neighborhood Services (Parks)
Rounds of golf played
Average rounds of golf played on playable days
Summary:
Milestone Estimated Actual
The redevelopment of Ditto Golf Course is one of Completion Completion
many redevelopment efforts in North Arlington.
A golf course master plan recently approved by
City Council, will include complete renovation of Phase 1 construction drawings June 2016 July 2016
the golf course, new clubhouse and maintenance complete
building, expanded driving range and a practice Phase 1 project bid Aug. 2016 Oct. 2016
facility. The golf course improvements will
provide a high‐quality playing experience at an Phase 1 construction begins Nov. 2016 Jan. 2017
affordable price point for Arlington residents Phase 2 construction drawings June 2017 June 2017
while providing another destination for visitors complete
to the Entertainment District and to help support Phase 2 project bid July 2017 Aug. 2017
Phase 2 construction contract Sept. 2017 Sept. 2017
economic development
award
Update: Phase 2 construction begins Sept. 2017 Nov. 2017
Phase 1 (Golf Course): Construction of the golf Phase 3 construction drawings Oct. 2017 Oct. 2017
course was completed in October 2017. complete
Phase 1 construction complete Nov. 2017 Sept. 2018
Phase 2 (Maintenance Package): The west Phase 3 project bid Nov. 2017 Nov. 2017
parking lot is complete. Fire lane and parking lot Phase 3 construction contract Dec. 2017 Dec. 2017
striping, and the cart paths at the pump house, award
driving range, and east side of the Clubhouse Phase 3 construction begins Mar. 2018 Mar. 2018
have been delayed due to recent rain. The cart Phase 2 construction complete Aug. 2018
paths and fire lane and parking lot striping are Golf course grand opening Sept. 2018
scheduled to be completed during the month of Phase 3 construction complete July 2019
November. The golf course is scheduled to Overall project completion July 2019
th
reopen November 28 .
Phase 3 (Clubhouse Package): This package
includes the clubhouse; basement cart storage;
east side of the Clubhouse parking lot, and
fencing. Fencing along Collins Street, Green Oaks
Boulevard, and a substantial portion along Brown
Boulevard is complete. Plumbing and foundation
walls for the basement were completed in
September. This phase is scheduled for
completion in the fall of 2019.
27
