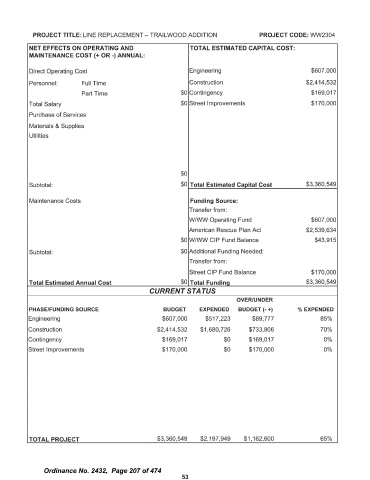

PROJECT TITLE:  LINE REPLACEMENT —  TRAILWOOD ADDITION                     PROJECT CODE:  WW2304

           NET  EFFECTS  ON  OPERATING   AND                    TOTAL ESTIMATED    CAPITAL COST:
           MAINTENANCE    COST (+   OR -)  ANNUAL:

           Direct Operatina Cost                                Engineering                              607, 000

           Personnel:       Full Time                           Construction                           2, 414, 532
                            Part Time                         0 Contingency                              169, 017
           Total Salary                                       0 Street Improvements                      170, 000
           Purchase of Services

           Materials &  Supplies
           Utilities






                                                              0
           Subtotal:                                          0 Total Estimated Capital Cost           3, 360, 549

           Maintenance  Costs                                   Funding Source:
                                                                Transfer  from:
                                                                W/WW Operating Fund                      607, 000
                                                                American Rescue Plan Act               2, 539, 634
                                                              0 W/ WW CIP Fund Balance                    43, 915

           Subtotal:                                          0 Additional Funding Needed:
                                                                Transfer  from:
                                                                Street CIP Fund Balance                  170, 000
           Total Estimated Annual Cost                        0 Total Funding                          3, 360, 549
                                                   CURRENT     STATUS
                                                                               OVER/ UNDER
           PHASE/ FUNDING  SOURCE                      BUDGET      EXPENDED     BUDGET (- +)          EXPENDED
          Engineering                                   607, 000      517, 223        89, 777              85%
          Construction                                2, 414, 532    1, 680, 726    733, 806               70%
          Contingency                                   169, 017            0        169, 017               0%
          Street Improvements                           170, 000            0        170, 000               0%
















           TOTAL  PROJECT                             3, 360, 549 $  2, 197, 949 $  1, 162, 600            65%





                Ordinance No.  2432,  Page 207 of 474
