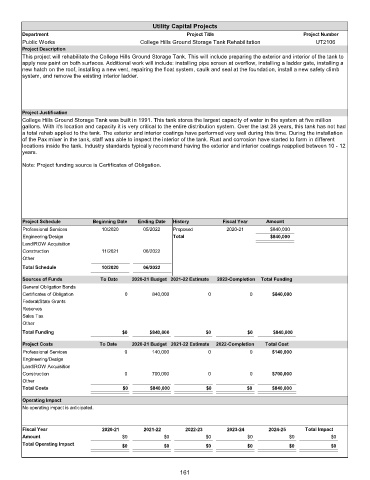

Utility Capital Projects
        Department                                             Project Title                         Project Number
        Public Works                           College Hills Ground Storage Tank Rehabilitation           UT2106
        Project Description
        This project will rehabilitate the College Hills Ground Storage Tank. This will include preparing the exterior and interior of the tank to
        apply new paint on both surfaces. Additional work will include: installing pipe screen at overflow, installing a ladder gate, installing a
        new hatch on the roof, installing a new vent, repairing the float system, caulk and seal at the foundation, install a new safety climb
        system, and remove the existing interior ladder.






        Project Justification
        College Hills Ground Storage Tank was built in 1991. This tank stores the largest capacity of water in the system at five million
        gallons. With it's location and capacity it is very critical to the entire distribution system. Over the last 28 years, this tank has not had
        a total rehab applied to the tank. The exterior and interior coatings have performed very well during this time. During the installation
        of the Pax mixer in the tank, staff was able to inspect the interior of the tank. Rust and corrosion have started to form in different
        locations inside the tank. Industry standards typically recommend having the exterior and interior coatings reapplied between 10 - 12
        years.
        Note: Project funding source is Certificates of Obligation.










        Project Schedule        Beginning Date  Ending Date  History       Fiscal Year   Amount
        Professional Services      10/2020      05/2022   Proposed          2020-21       $840,000
        Engineering/Design                                Total                           $840,000
        Land/ROW Acquisition
        Construction               11/2021      06/2022
        Other
        Total Schedule             10/2020      06/2022
        Sources of Funds          To Date    2020-21 Budget 2021-22 Estimate  2022-Completion  Total Funding
        General Obligation Bonds
        Certificates of Obligation        0        840,000            0             0      $840,000
        Federal/State Grants
        Reserves
        Sales Tax
        Other
        Total Funding                    $0        $840,000          $0            $0      $840,000
        Project Costs             To Date    2020-21 Budget 2021-22 Estimate  2022-Completion  Total Cost
        Professional Services             0        140,000            0             0      $140,000
        Engineering/Design
        Land/ROW Acquisition
        Construction                      0        700,000            0             0      $700,000
        Other
        Total Costs                       $0       $840,000          $0            $0      $840,000
        Operating Impact
        No operating impact is anticipated.


        Fiscal Year                2020-21       2021-22      2022-23       2023-24       2024-25     Total Impact
        Amount                           $0            $0            $0            $0            $0            $0
        Total Operating Impact           $0            $0            $0            $0            $0            $0
