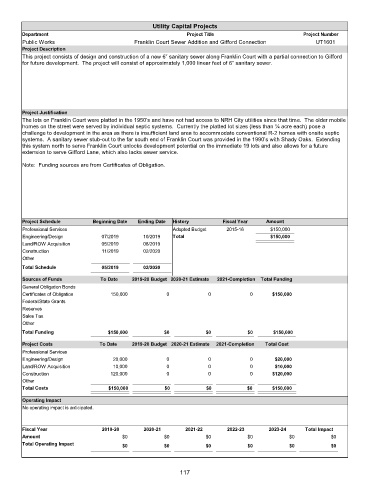

Page 127 - NRH FY20 Approved Capital Budget
P. 127

Utility Capital Projects
        Department                                             Project Title                         Project Number
        Public Works                         Franklin Court Sewer Addition and Gifford Connection         UT1601
        Project Description
        This project consists of design and construction of a new 6” sanitary sewer along Franklin Court with a partial connection to Gifford
        for future development.  The project will consist of approximately 1,000 linear feet of 6” sanitary sewer.









        Project Justification
        The lots on Franklin Court were platted in the 1950’s and have not had access to NRH City utilities since that time.  The older mobile
        homes on the street were served by individual septic systems.  Currently the platted lot sizes (less than ¼ acre each) pose a
        challenge to development in the area as there is insufficient land area to accommodate conventional R-2 homes with onsite septic
        systems.  A sanitary sewer stub-out to the far south end of Franklin Court was provided in the 1990’s with Shady Oaks.  Extending
        this system north to serve Franklin Court unlocks development potential on the immediate 19 lots and also allows for a future
        extension to serve Gifford Lane, which also lacks sewer service.
        Note:  Funding sources are from Certificates of Obligation.










        Project Schedule        Beginning Date  Ending Date  History       Fiscal Year   Amount
        Professional Services                             Adopted Budget    2015-16       $150,000
        Engineering/Design         07/2019      10/2019   Total                           $150,000
        Land/ROW Acquisition       05/2019      08/2019
        Construction               11/2019      02/2020
        Other
        Total Schedule             05/2019      02/2020
        Sources of Funds          To Date    2019-20 Budget 2020-21 Estimate  2021-Completion  Total Funding
        General Obligation Bonds
        Certificates of Obligation    150,000           0             0             0      $150,000
        Federal/State Grants
        Reserves
        Sales Tax
        Other
        Total Funding                $150,000          $0            $0            $0      $150,000
        Project Costs             To Date    2019-20 Budget 2020-21 Estimate  2021-Completion  Total Cost
        Professional Services
        Engineering/Design            20,000            0             0             0       $20,000
        Land/ROW Acquisition          10,000            0             0             0       $10,000
        Construction                  120,000           0             0             0      $120,000
        Other
        Total Costs                  $150,000          $0            $0            $0      $150,000
        Operating Impact
        No operating impact is anticipated.


        Fiscal Year                2019-20       2020-21      2021-22       2022-23       2023-24     Total Impact
        Amount                            $0           $0            $0            $0            $0            $0
        Total Operating Impact            $0           $0            $0            $0            $0            $0
