Page 239 - CityofEulessFY26AdoptedBudgetOrdinance2432
P. 239

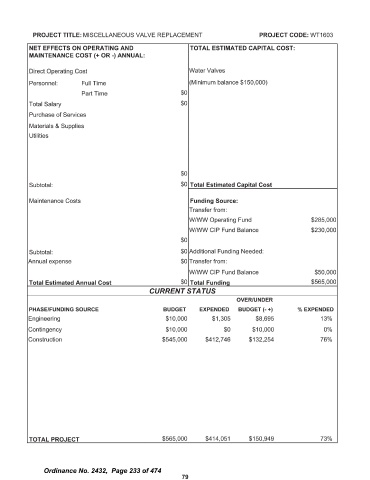

PROJECT TITLE:  MISCELLANEOUS     VALVE REPLACEMENT                        PROJECT CODE:  WT1603

           NET  EFFECTS  ON  OPERATING   AND                    TOTAL  ESTIMATED   CAPITAL  COST:
           MAINTENANCE    COST (+   OR -)  ANNUAL:

           Direct Operatina Cost                                Water  Valves

           Personnel:       Full Time                           Minimum  balance $  150, 000)
                            Part Time                         0
           Total Salary                                       0
           Purchase of Services

           Materials &   Supplies
           Utilities






                                                              0
           Subtotal: $                                        0 Total Estimated Capital Cost

           Maintenance  Costs                                   Funding Source:
                                                                Transfer  from:
                                                                W/WW Operating Fund                      285, 000
                                                                W/ WW CIP Fund Balance                   230, 000
                                                              0

           Subtotal: $                                        0 Additional  Funding Needed:
          Annual expense $                                    0 Transfer from:
                                                                W/ WW CIP Fund Balance                    50, 000
           Total Estimated Annual Cost $                      0 Total Funding                            565, 000
                                                   CURRENT STATUS
                                                                               OVER/ UNDER
           PHASE/ FUNDING  SOURCE                      BUDGET      EXPENDED     BUDGET (- +) %        EXPENDED
          Engineering $                                  10, 000 $      1, 305 $       8, 695              13%
          Contingency $                                  10, 000 $          0 $       10, 000               0%
          Construction $                                545, 000 $    412, 746 $     132, 254              76%


















           TOTAL  PROJECT                               565, 000 $    414, 051 $     150, 949              73%





                Ordinance No.  2432,  Page 233 of 474
