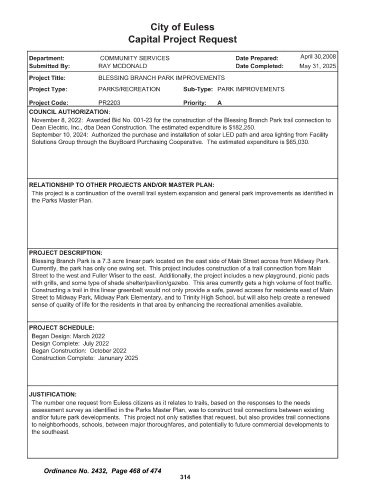

                                            Capital Project Request

                                                                                                    April 30, 2008
           Department:            COMMUNITY    SERVICES                        Date  Prepared:
           Submitted By:          RAY  MCDONALD                                Date Completed:      May 31,  2025
           Project Title:         BLESSING  BRANCH PARK IMPROVEMENTS
           Project  Type:         PARKS/ RECREATION           Sub - Type:   PARK  IMPROVEMENTS

           Project Code:          PR2203                      Priority:   A
           COUNCIL  AUTHORIZATION:
            November 8,  2022:  Awarded Bid No.  001- 23 for the construction of the Blessing Branch Park trail connection to
            Dean Electric,  Inc.,  dba Dean Construction.  The estimated expenditure  is $ 182, 250.
            September 10,  2024:  Authorized the purchase and installation of solar LED path and area lighting from Facility
            Solutions Group through the BuyBoard Purchasing Cooperative.  The estimated expenditure is $ 65,030.







           RELATIONSHIP   TO OTHER PROJECTS AND/ OR MASTER PLAN:
           This project is a continuation  of the overall trail system expansion and general park improvements  as identified  in
           the  Parks  Master  Plan.









           PROJECT   DESCRIPTION:
            Blessing Branch Park is a 7.3 acre linear park located on the east side of Main Street across from Midway Park.
            Currently,  the park has only one swing set.  This project includes construction of a trail connection from Main
            Street to the west and Fuller Wiser to the east.  Additionally, the project includes a new playground,  picnic pads
           with grills, and some type of shade shelter/pavilion/ gazebo.  This area currently gets a high volume of foot traffic.
            Constructing a trail in this linear greenbelt would not only provide a safe,  paved access for residents east of Main
            Street to Midway Park,  Midway Park Elementary, and to Trinity High School,  but will also help create a renewed
            sense of quality of life for the residents in that area by enhancing the recreational amenities available.


           PROJECT SCHEDULE:
            Began  Design:   March  2022
            Design Complete:  July 2022
            Began Construction:   October 2022
            Construction Complete:  Janunary 2025





           JUSTIFICATION:
           The number one request from Euless citizens as it relates to trails,  based on the responses to the needs
            assessment survey as identified in the Parks Master Plan,  was to construct trail connections between existing
            and/ or future park developments.  This project not only satisfies that request, but also provides trail connections
           to neighborhoods,  schools,  between major thoroughfares,  and potentially to future commercial developments to
           the southeast.






                Ordinance No.  2432,  Page 468 of 474
