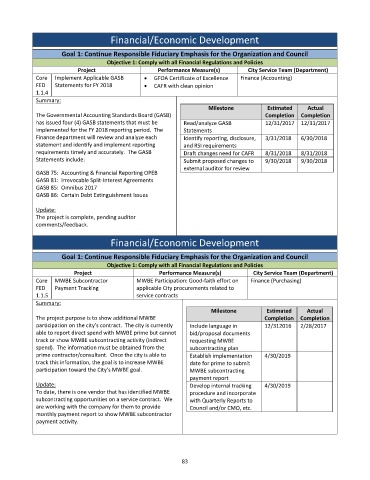

Page 414 - City of Arlington FY19 Adopted Operating Budget
P. 414
Financial/Economic Development
Goal 1: Continue Responsible Fiduciary Emphasis for the Organization and Council
Objective 1: Comply with all Financial Regulations and Policies
Project Performance Measure(s) City Service Team (Department)
Core Implement Applicable GASB GFOA Certificate of Excellence Finance (Accounting)
FED Statements for FY 2018 CAFR with clean opinion
1.1.4
Summary:
Milestone Estimated Actual
The Governmental Accounting Standards Board (GASB) Completion Completion
has issued four (4) GASB statements that must be Read/analyze GASB 12/31/2017 12/31/2017
implemented for the FY 2018 reporting period. The Statements
Finance department will review and analyze each Identify reporting, disclosure, 3/31/2018 6/30/2018
statement and identify and implement reporting and RSI requirements
requirements timely and accurately. The GASB Draft changes need for CAFR 8/31/2018 8/31/2018
Statements include: Submit proposed changes to 9/30/2018 9/30/2018
external auditor for review
GASB 75: Accounting & Financial Reporting OPEB
GASB 81: Irrevocable Split‐Interest Agreements
GASB 85: Omnibus 2017
GASB 86: Certain Debt Extinguishment Issues
Update:
The project is complete, pending auditor
comments/feedback.
Financial/Economic Development
Goal 1: Continue Responsible Fiduciary Emphasis for the Organization and Council
Objective 1: Comply with all Financial Regulations and Policies
Project Performance Measure(s) City Service Team (Department)
Core MWBE Subcontractor MWBE Participation: Good‐faith effort on Finance (Purchasing)
FED Payment Tracking applicable City procurements related to
1.1.5 service contracts
Summary:
Milestone Estimated Actual
The project purpose is to show additional MWBE Completion Completion
participation on the city’s contract. The city is currently Include language in 12/312016 2/28/2017
able to report direct spend with MWBE prime but cannot bid/proposal documents
track or show MWBE subcontracting activity (indirect requesting MWBE
spend). The information must be obtained from the subcontracting plan
prime contractor/consultant. Once the city is able to Establish implementation 4/30/2019
track this information, the goal is to increase MWBE date for prime to submit
participation toward the City’s MWBE goal. MWBE subcontracting
payment report
Update: Develop internal tracking 4/30/2019
To date, there is one vendor that has identified MWBE procedure and incorporate
subcontracting opportunities on a service contract. We with Quarterly Reports to
are working with the company for them to provide Council and/or CMO, etc.
monthly payment report to show MWBE subcontractor
payment activity.
83
