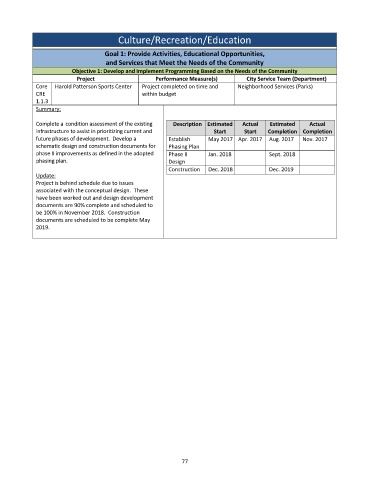

                                    Goal 1: Provide Activities, Educational Opportunities,
                                    and Services that Meet the Needs of the Community
                         Objective 1: Develop and Implement Programming Based on the Needs of the Community
                          Project                   Performance Measure(s)         City Service Team (Department)
             Core   Harold Patterson Sports Center   Project completed on time and   Neighborhood Services (Parks)
             CRE                                within budget
             1.1.3
             Summary:

             Complete a condition assessment of the existing   Description  Estimated   Actual   Estimated   Actual
             infrastructure to assist in prioritizing current and       Start     Start   Completion  Completion
             future phases of development.  Develop a    Establish    May 2017   Apr. 2017  Aug. 2017   Nov. 2017
             schematic design and construction documents for   Phasing Plan
             phase II improvements as defined in the adopted   Phase II   Jan. 2018       Sept. 2018
             phasing plan.                               Design
                                                         Construction   Dec. 2018         Dec. 2019
             Update:
             Project is behind schedule due to issues
             associated with the conceptual design.  These
             have been worked out and design development
             documents are 90% complete and scheduled to
             be 100% in November 2018.  Construction
             documents are scheduled to be complete May
             2019.
